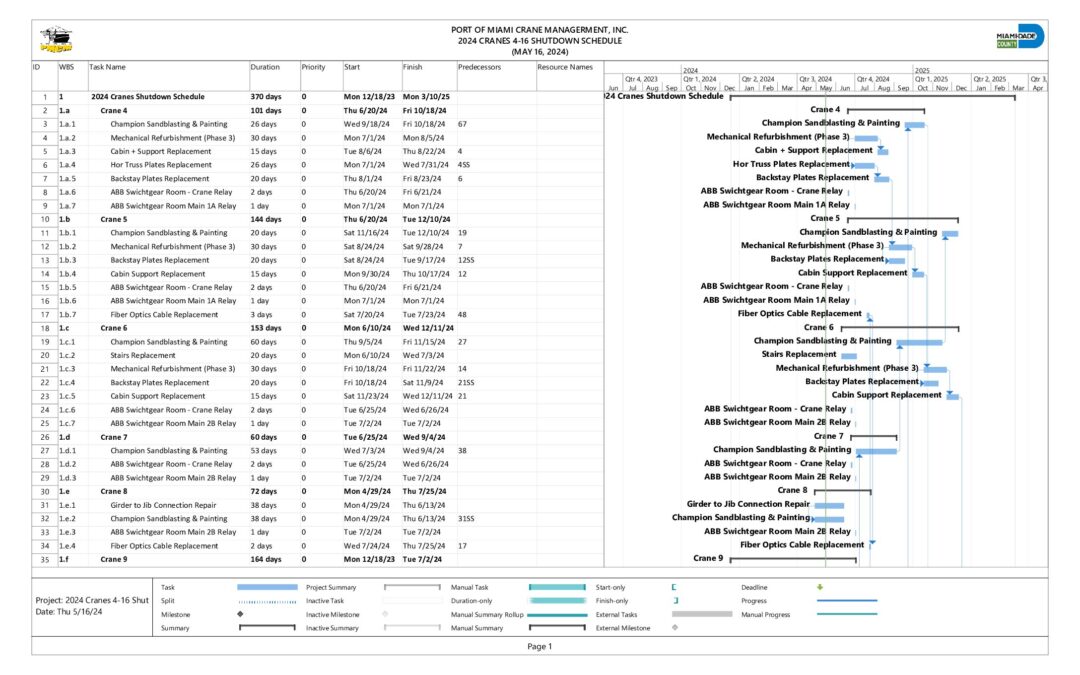

2024 Cranes 4-16 Shutdown Schedule (5.16.24) – Page 1

by Alejandro Natera | May 17, 2024
